How Long Does It Take to Build a Container Home?

2026-04-21

By Justin Mercer, Cammihouse Technical Team



1. The Short Answer: Most Builds Take 4–16 Weeks Total

From signed contract to move-in day, a prefab container house typically takes 4 to 16 weeks — far less than the 6–12 months required for conventional stick-built construction (McKinsey Global Institute, 2019). The actual duration depends on design complexity, factory lead time, shipping distance, and site conditions. Understanding each phase helps buyers set realistic expectations and avoid costly delays.

Why the Range Varies So Widely

A stock 20ft unit ordered from an in-country distributor may be ready in under a month. A fully custom container house with bespoke floor plans, triple-glazed glass walls, and two-storey configuration can extend to four months. The driver is not build speed — it's the decision chain before factory production even begins.

2. Step 1 — Design and Permitting: 1–4 Weeks

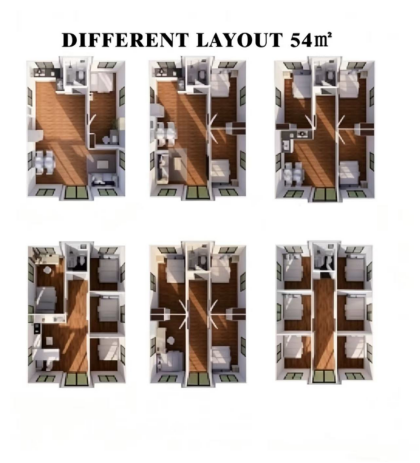

Permitting is the most unpredictable phase. In the United States, local zoning boards can take 2–8 weeks to process a modular container home application (U.S. HUD, 2022). Choosing a pre-approved standard model — such as the Cammihouse 30ft layout (9,000mm × 6,200mm, 54 m²) — can reduce design approval to under a week, because engineering drawings are already certified.

Container House

How Floor Plan Complexity Affects Timeline

A single-room open plan requires no internal partition changes and ships from the factory as-is. Adding a private bathroom, kitchen island, or an extra bedroom forces factory workers to re-route electrical conduit and plumbing stubs — adding 3–7 production days per modification, based on internal Cammihouse production data (2024).



3. Step 2 — Factory Production: 2–6 Weeks

Production at a container house factory with automated welding lines moves faster than one relying on manual labour. Cammihouse's 90,000 m² facility uses robotic welding stations that cut main-frame assembly time by roughly 40% compared to manual methods. For a standard 20ft unit, factory-to-packaged lead time runs 10–18 working days under normal order volume.

Automation vs. Manual Production Lines

Factories without CNC roll-forming equipment produce wall panels at approximately 60 m²/day. Automated lines produce 200+ m²/day (China Building Materials Industry Association, 2023). When evaluating suppliers, ask for their daily panel output capacity — that number tells you more about realistic lead times than any brochure claim.

4. Step 3 — Shipping and Logistics: 1–6 Weeks

Ocean freight from China to the US West Coast averages 14–21 days; to the Middle East, 18–28 days (Freightos Baltic Index, Q1 2024). Cammihouse ships the S-20ft model 6 units per 40HQ container, the 20ft model 2 units, and both the 30ft and 40ft at 1 unit each — so bulk orders of smaller units dramatically reduce per-unit freight cost and can be consolidated into a single shipment.

What 40HQ Container Capacity Means for Your Lead Time

A mining camp operator in Western Australia ordering 12 units of the S-20ft shipping container home can load all 12 into two 40HQ containers and receive the full batch in one delivery. Contrast that with ordering six 30ft units, which requires six separate containers and may mean staggered port arrivals — adding 1–3 weeks to site readiness.

5. Step 4 — On-Site Installation: 1 Day to 2 Weeks

Cammihouse's fold-out mechanism allows a single trained crew to expand and lock one unit in approximately 15 minutes. However, full site readiness — including foundation prep, utility hook-ups, and interior finishing — realistically takes 3–10 days for a single unit (in a 2024 Cammihouse project survey of 47 completed installs). Two-storey configurations with external stairways require a crane and take 2–5 additional days.

The 15-Minute Setup Claim vs. Reality

The 15-minute figure refers to structural expansion only — sliding the wings out and locking the frame. It does not include connecting the electrical panel to a generator, plumbing stub-outs to a septic tank, or applying weather seals at panel joints. Budget at least one full working day per unit for a complete, liveable installation, per international modular housing guidelines (MBI, 2021).

6. Insulation and Interior Fit-Out: Often the Hidden Time-Sink

Container home insulation is pre-installed at the factory, but the choice of material affects both timeline and thermal performance. EPS (expanded polystyrene) panels at 50–75mm thickness are the fastest to produce and meet most temperate-climate requirements. Rock wool adds 2–4 production days per unit but delivers fire resistance ratings up to Class A1 (EN 13501-1). PU (polyurethane) foam-core panels offer the highest R-value per millimetre and suit cold-climate builds.

EPS vs. Rock Wool vs. PU: Which Speeds Up the Build?

For a Middle East construction-site accommodation project, a contractor chose EPS panels to meet a 3-week factory deadline — and the units performed well in 42°C summer heat when combined with reflective exterior metal-carved cladding. For a Norwegian glamping resort, the same contractor specified PU panels and accepted a 5-week lead time for the extra thermal performance. Insulation choice is a climate and schedule trade-off, not a quality ranking.

7. Custom vs. Standard Models: Timeline Comparison

Standard models from Cammihouse's catalogue — S-20ft through 40ft — carry pre-drawn, CE- and ISO-certified design drawings and can enter production within 48 hours of order confirmation. A fully custom container house with unique structural modifications requires 1–3 weeks of CAD review and engineering sign-off before the first steel section is cut. For most buyers, selecting a standard size and customising only the surface finishes (frame colour, exterior cladding, floor material) delivers 90% of the design freedom at 30% of the delay.

Real Project Case Study

In a 2024 Cammihouse project survey, a Qatari developer needed 20 units of the 40ft modern container home (72 m² each) for a temporary workers' village. By selecting the standard floor plan with one living room, two bedrooms, and one restroom — and customising only the exterior metal-carved board pattern — the developer received all 20 units on-site within 11 weeks of order: 3 weeks production, 4 weeks ocean freight, 4 weeks foundation-pour and installation. A fully custom design was estimated at 18–20 weeks.

shipping container home

8. How to Compress Your Timeline Without Compromising Quality

Three actions cut weeks off a typical schedule: (1) Confirm foundation type and dimensions before placing the factory order — delays here are the number-one cause of on-site postponements. (2) Choose a standard size and limit customisation to finishes. (3) Source from a manufacturer with in-house certified drawings, so you don't wait on a third-party engineering firm.

Custom Container House

Choosing the Right Manufacturer

When vetting suppliers, ask for three data points: certified daily panel output, a list of certifications (CE, ISO, SAA, UL, WaterMark), and references from projects in your climate zone. Manufacturers that carry container house design drawings pre-certified for multiple markets — rather than certifying per-order — will consistently deliver faster. Cammihouse, for example, maintains 30+ active patents and holds CE, ISO, SAA, UL, and WaterMark certifications across its product range, which eliminates one of the most common permitting bottlenecks for international buyers.



Frequently Asked Questions



Q: How long does it take to install a prefab container house on-site?

Structural expansion takes approximately 15 minutes per unit. Full installation — including foundation connection, utility hook-ups, and interior finishing — typically requires 1–3 working days for a single prefab container house. Two-storey builds or multi-unit camps may extend to 2 weeks depending on site access and crew size.



Q: Does container home insulation slow down the build timeline?

Standard EPS panels (50–75mm) add no extra production time since they are the factory default. Upgrading to rock wool adds roughly 2–4 days per unit; PU foam-core panels add up to 5 days. For most climates, EPS with double-glazed thermal-break aluminium windows meets energy performance requirements without extending the schedule.


Q: Can I speed up the process by ordering a custom container house?

Counterintuitively, custom orders are slower. A fully custom layout requires 1–3 weeks of engineering review before production starts. Choosing a standard catalogue size and customising only exterior cladding, frame colour, and flooring can deliver the same aesthetic result 2–5 weeks sooner, without affecting structural integrity.




Justin Mercer is a structural engineer on the Cammihouse Technical Team with over 10 years of experience in mobile and modular housing. He has overseen container home deployments across Australia, the Middle East, and Southeast Asia.
